Underbank Newsletter Updates - February 2026

Underbank Construction Updates



River View

Construction works for Stage S1301 have been completed. Titles have been issued and settlement has occurred.


Park View

Construction of Stages 21–22 is nearing completion.

Preliminary practical completion inspections by Council have been undertaken, with the formal inspection scheduled next week.

Our consultants are liaising with the relevant authorities to secure consent for the Statement of Compliance (SOC) as soon as possible. Currently forecasts SOC issuance in approximately four weeks, subject to no delays from servicing authorities.



Town Centre

The Moorabool Shire Retail Strategy is expected to receive Ministerial approval in late 2026, after which Council will be able to proceed with the Town Centre rezoning process.



Sports Precinct

The planning permit approval is expected shortly.

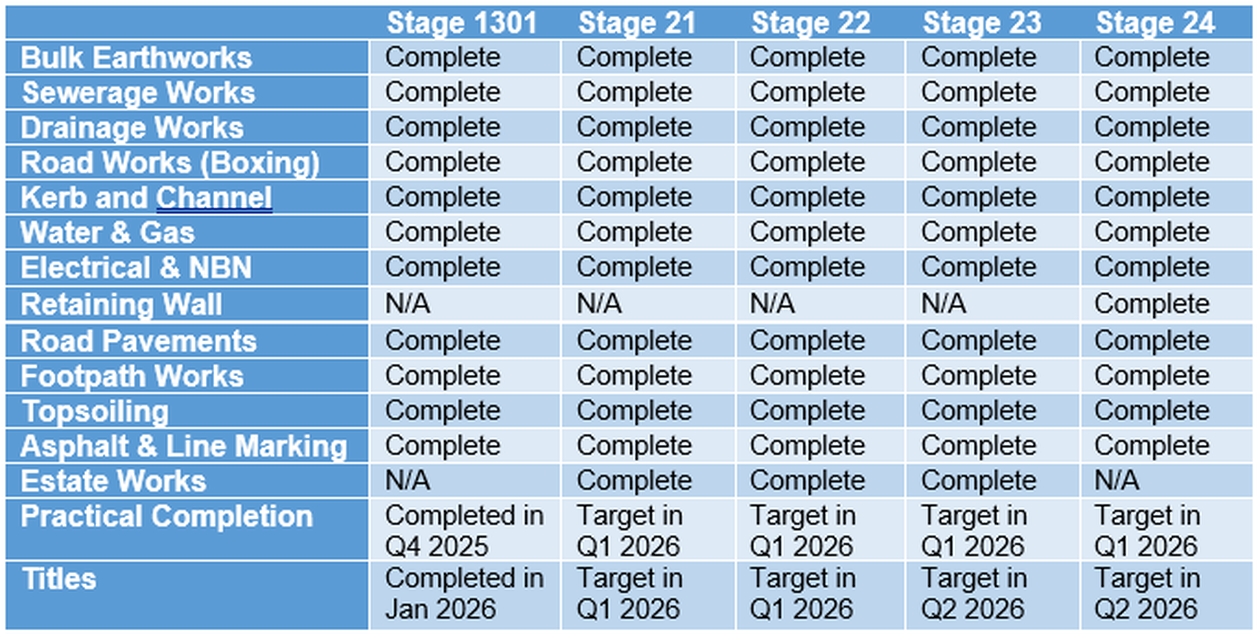

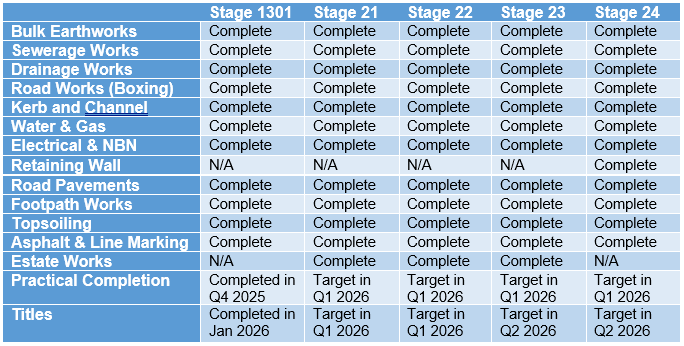

Feb








River View (S901 Townhouse)



S901

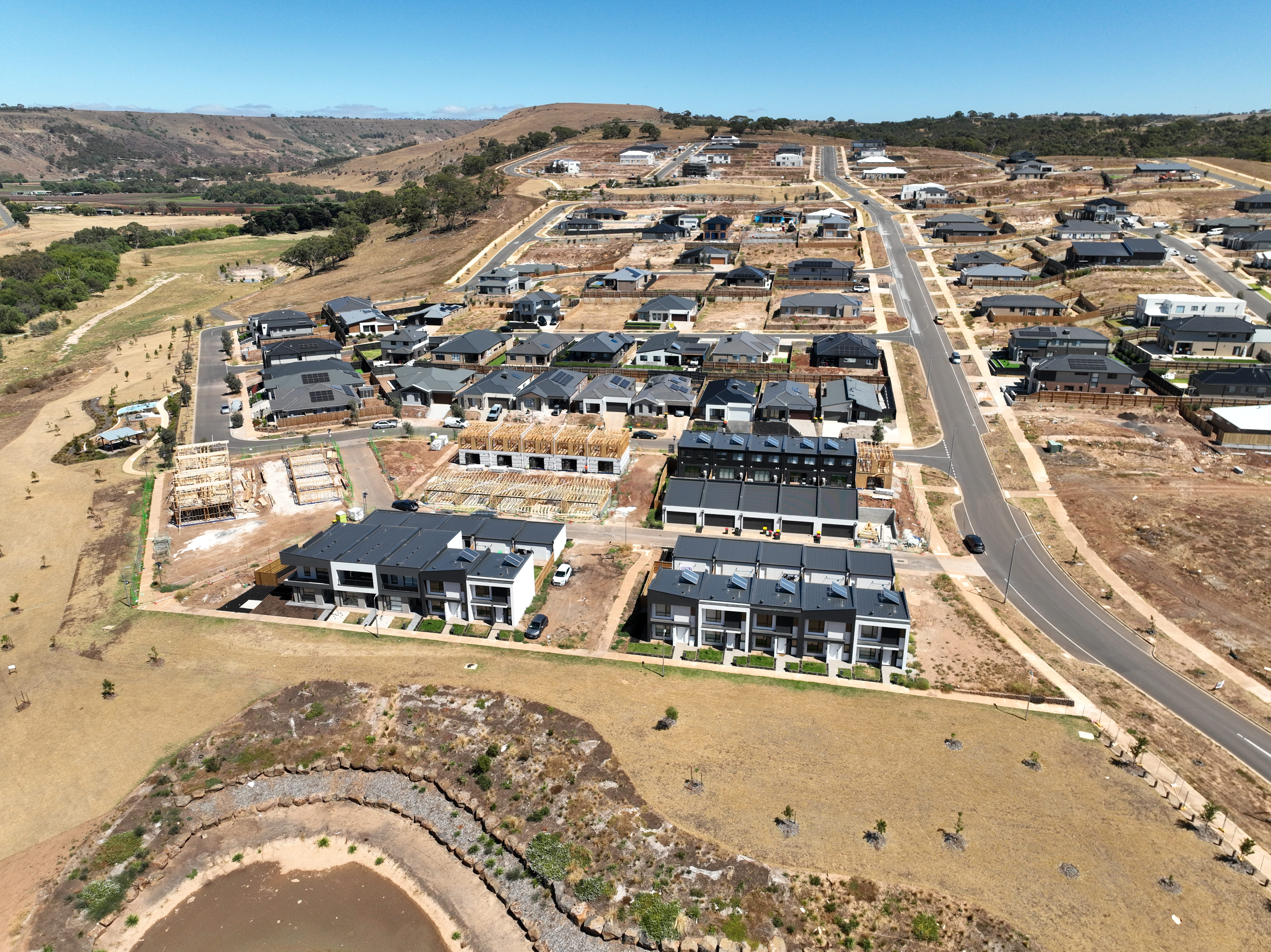

Stage S901 Townhomes – The balance of S901 building construction is underway and nearing completion.



River View (S1301)





S1301

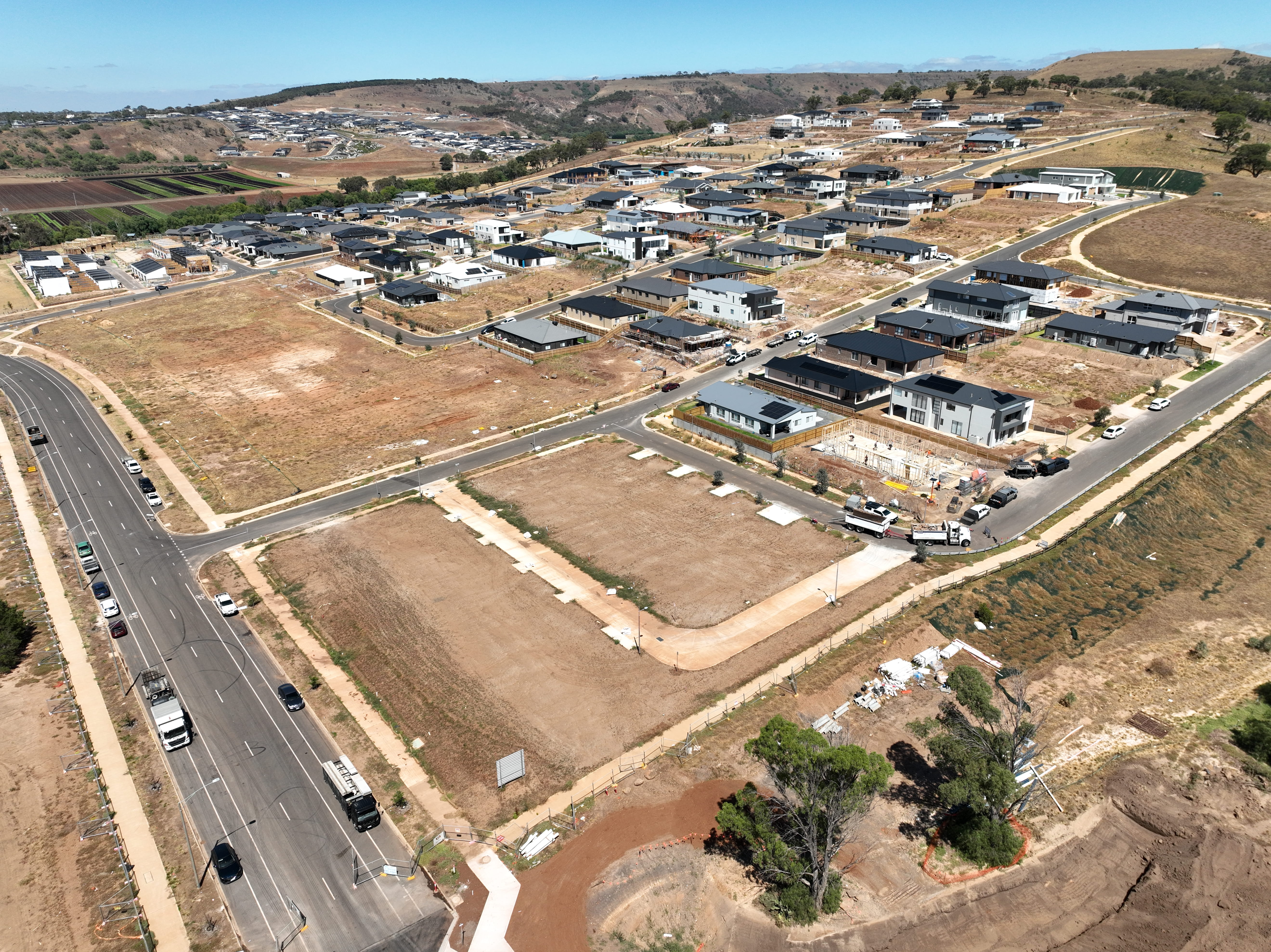

Construction works for Stage S1301 have been completed. Titles have been issued and settlement has occurred.





Park View (21-24)

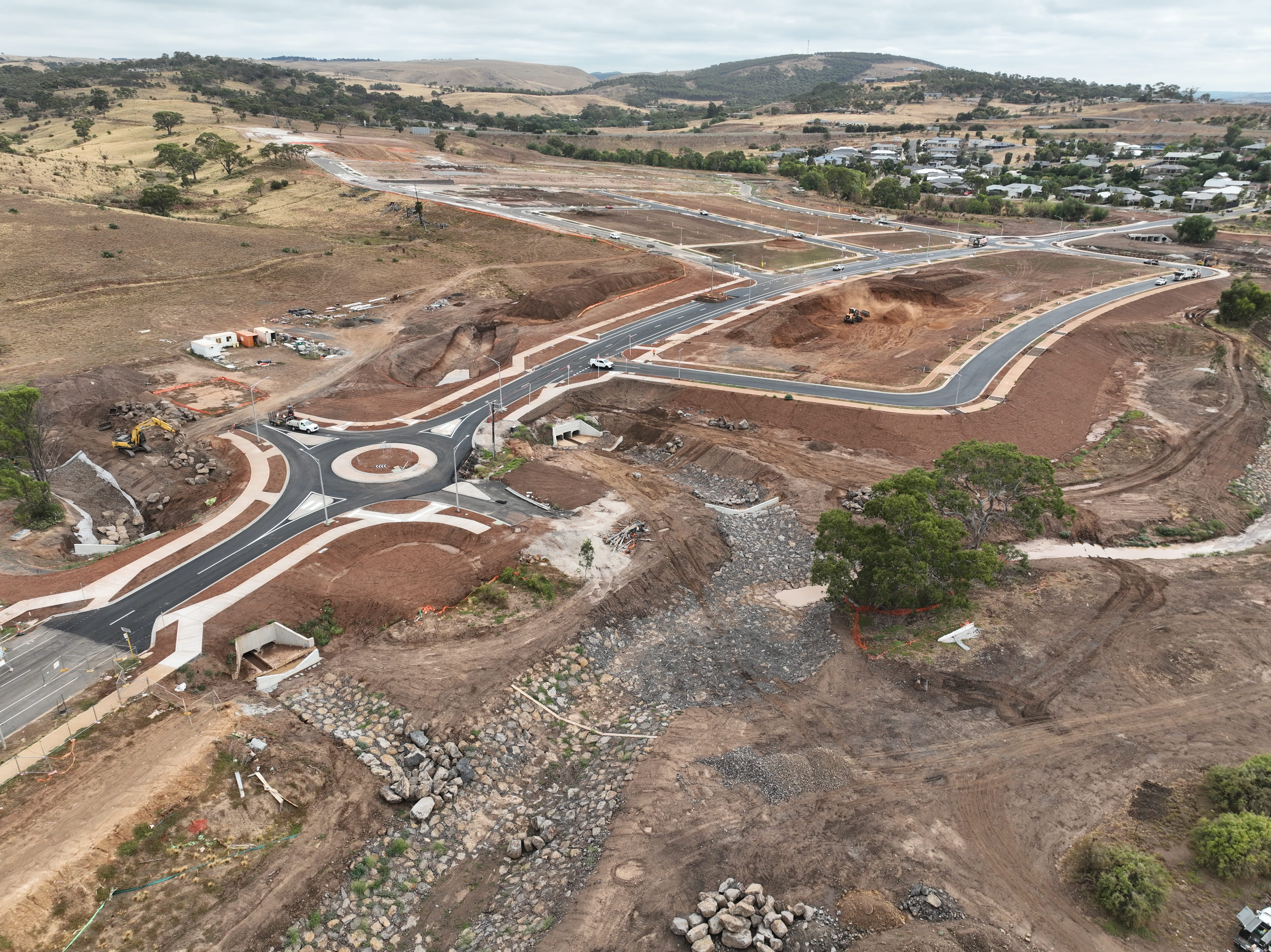

mini culert



Main roads and intersections (including a roundabout) have been constructed and line-marked. Kerbs and footpaths are largely complete, bulk earthworks and lot benching are substantially finished, and drainage channels and rock-lined embankments are in place.





Big culvert

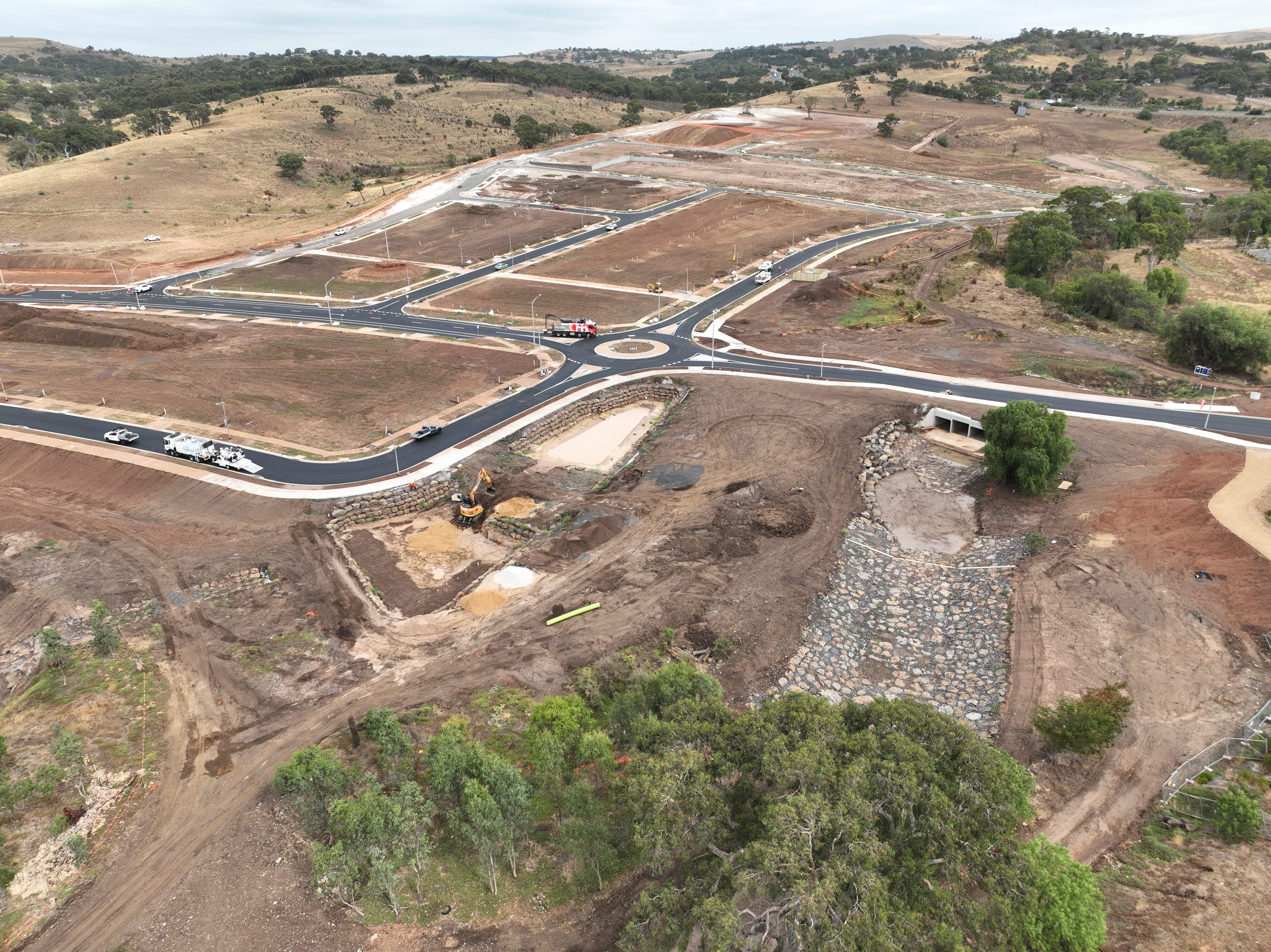

Randwick Avenue culvert structure completed, including headwall and base slab.







We thank you for your continued support and patience, and look forward to sharing more exciting updates with you soon.
